Commercial Projects

At Cuzons, we specialise in delivering seamless mechanical and electrical (M&E) solutions tailored to the unique demands of industrial and commercial sectors.

Cuzons Graphics-146.png

10 White Lion St, Angel, London, N1


Full CATB fit out inclusive of modification works to existing lighting and new feature lighting using galvanised conduit systems to the exposed ceiling. New underfloor containment, hard wired floor boxes, new Cat6 data cabling throughout and rack mounted UPS.

10 White Lion Street, Angel, London, N1.

Approx 12 Weeks duration.


Sundial House, 114 Kensington High St, London, W8 4NP.

Full CAT A+ fit out inclusive of new suspended linear lighting throughout, hard wired floor boxes, new Cat6 data cabling throughout.

Approx 8 weeks duration.

966 11 PROBITAS EXCEK Photo DC.jpg

5th Floor, Leadenhall Street, London, EC3A.

Full CATB fit out inclusive of modification works to existing lighting and new feature lighting, New underfloor containment, hard wired floor boxes, new Cat6 data cabling throughout.



Approx 12 Weeks duration.


For our esteemed client, a leading media company

For our esteemed client, a leading media company, we completed a comprehensive electrical Cat A to Cat B Commercial Fit-Out. This project encompassed the installation of new lighting, power, and data systems, along with a new Distribution Board dedicated to the Comms Room. We also upgraded the existing Tenants Distribution Board to enhance overall capacity and reliability. The project was concluded with a thorough inspection, testing, and certification to ensure compliance with the highest standards.


3rd & 4th Floor(s), 31 Dover Street, London, W1S.

Full CATA+ fit out inclusive of new lighting to 3rd floor and modification to existing lighting on the 4th floor, hard wired floor boxes, new Cat6 data cabling throughout. New lighting throughout common parts and stairwells within the landlord demise.

Approx 8 weeks duration.

Screenshot 2024-08-14 at 13.22.05.png

A marquee project that everyone involved can be extremely proud of!

Landhold Developments' initial phase of 31 high-end apartments and common areas, where luxury meets functionality! We're honoured to lead the M&E provision, ensuring every detail is perfected. Including lighting, power, fire alarm, access control, smoke damper controls, plumbing, heating & ventilation. Essco Group supplied the impressive 375kW (pre-built) plantroom that was lifted onto the roof of the building by our colleagues at Southern Cranes & Access Ltd. Boosted cold water tank was provided by Dutypoint and all Air Handling Units were from VentZone team.

10 White Lion St, Angel, London, N1

Client: Space
For: PureGym


Full CATB fit out inclusive of modification works to existing lighting and new feature lighting using galvanised conduit systems to the exposed ceiling. New underfloor containment, hard wired floor boxes, new Cat6 data cabling throughout and rack mounted UPS.

10 White Lion Street, Angel, London, N1.

Approx 12 Weeks duration.

Sundial House, 114 Kensington High St, London, W8 4NP.

Client: Space

Full CAT A+ fit out inclusive of new suspended linear lighting throughout, hard wired floor boxes, new Cat6 data cabling throughout.

Approx 8 weeks duration.

5th Floor, Leadenhall Street, London, EC3A.

Client: Space

Full CATB fit out inclusive of modification works to existing lighting and new feature lighting, New underfloor containment, hard wired floor boxes, new Cat6 data cabling throughout.

Approx 12 Weeks duration

For our esteemed client, a leading media company

Client: 8build

For our esteemed client, a leading media company, we completed a comprehensive electrical Cat A to Cat B Commercial Fit-Out. This project encompassed the installation of new lighting, power, and data systems, along with a new Distribution Board dedicated to the Comms Room. We also upgraded the existing Tenants Distribution Board to enhance overall capacity and reliability. The project was concluded with a thorough inspection, testing, and certification to ensure compliance with the highest standards.

3rd & 4th Floor(s), 31 Dover Street, London, W1S.

Client: Space

Full CATA+ fit out inclusive of new lighting to 3rd floor and modification to existing lighting on the 4th floor, hard wired floor boxes, new Cat6 data cabling throughout. New lighting throughout common parts and stairwells within the landlord demise.

Approx 8 weeks duration.

A marquee project that everyone involved can be extremely proud of!

Client: Landhold

Landhold Developments' initial phase of 31 high-end apartments and common areas, where luxury meets functionality! We're honoured to lead the M&E provision, ensuring every detail is perfected. Including lighting, power, fire alarm, access control, smoke damper controls, plumbing, heating & ventilation. Essco Group supplied the impressive 375kW (pre-built) plantroom that was lifted onto the roof of the building by our colleagues at Southern Cranes & Access Ltd. Boosted cold water tank was provided by Dutypoint and all Air Handling Units were from VentZone team.

The Social Construct Headers-225.png

Industrial Projects

At Cuzons, we specialise in delivering seamless mechanical and electrical (M&E) solutions tailored to the unique demands of industrial and commercial sectors.


London Heathrow Airport – Terminal 2 Direct System Std. 3 HBS Upgrade

Installation of a new baggage system within Terminal 2. Installation was completed in a

phased approach to ensure there was no impact to live operation. The existing system (approx. 1.2m of conveyor) was decommissioned and removed before being replaced with a new system including the integration of 7 no. Std. 3 HBS machines to ensure the airport achieved Std.3 DfT compliance.


London Heathrow Airport – Terminal 4 Transfer System Std. 3 HBS Upgrade

Installation of a new transfers baggage system within Terminal 4. The project scope was to

decommission and remove the existing HBS system and integrate a new HBS system to

ensure DfT compliance without impacting airport operations which remained live throughout.


London Heathrow Airport – Terminal 2 Out of Gauge Std. 3 HBS Upgrade

Upgrade of the Out of Gauge Baggage conveyor system and integration of 2 no. new Std.3 EDS machines, including development and implementation of temporary operational mitigations to ensure no operational impact. Completion of this project on time ensured that the airport achieved DfT compliance.

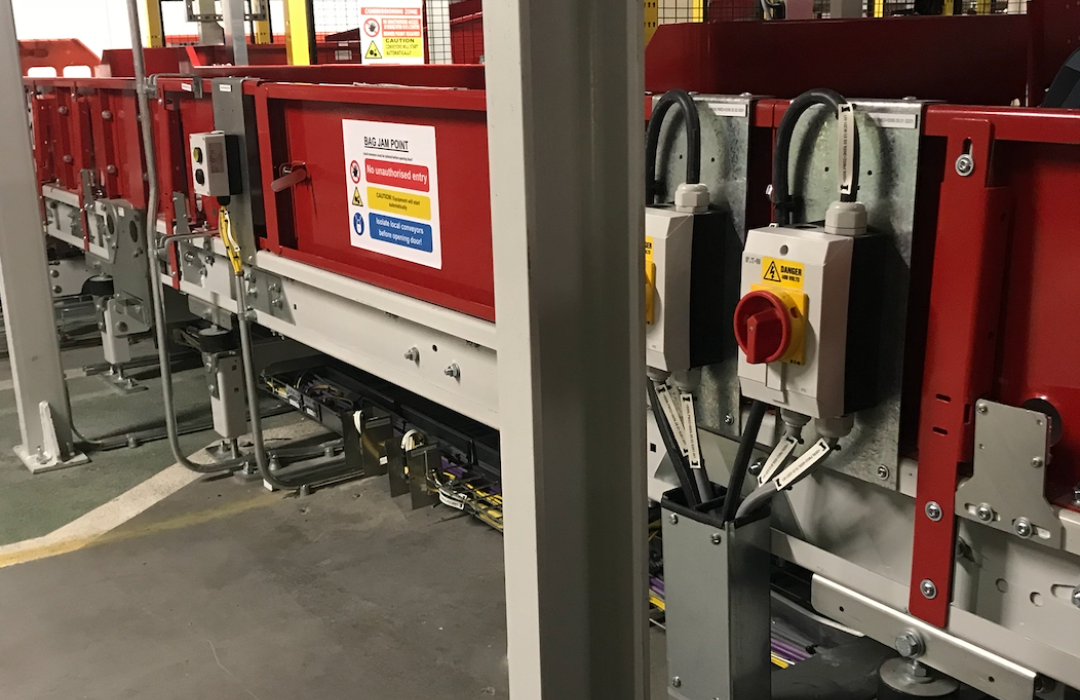

Screenshot 2024-08-14 at 13.28.56.png

London Stansted Airport – Std 3. HBS Upgrade Project

Installation of new HBS baggage system at Stansted Airport without impacting live

operations. Project scope includes, surveys, enabling and constraints removal, M&E

installation, connections to the existing system and implementation of appropriate operational

mitigations. This project will be the first installation of a DCV system in the UK and will

ensure Std. 3 DfT compliance for the airport.

London Heathrow Airport – Terminal 2 Direct System Std. 3 HBS Upgrade

Installation of a new baggage system within Terminal 2. Installation was completed in a

phased approach to ensure there was no impact to live operation. The existing system (approx. 1.2m of conveyor) was decommissioned and removed before being replaced with a new system including the integration of 7 no. Std. 3 HBS machines to ensure the airport achieved Std.3 DfT compliance.

London Heathrow Airport – Terminal 4 Transfer System Std. 3 HBS Upgrade

Installation of a new transfers baggage system within Terminal 4. The project scope was to

decommission and remove the existing HBS system and integrate a new HBS system to

ensure DfT compliance without impacting airport operations which remained live throughout.

London Heathrow Airport – Terminal 2 Out of Gauge Std. 3 HBS Upgrade

Upgrade of the Out of Gauge Baggage conveyor system and integration of 2 no. new Std.3 EDS machines, including development and implementation of temporary operational mitigations to ensure no operational impact. Completion of this project on time ensured that the airport achieved DfT compliance.

London Stansted Airport – Std 3. HBS Upgrade Project

Installation of new HBS baggage system at Stansted Airport without impacting live

operations. Project scope includes, surveys, enabling and constraints removal, M&E

installation, connections to the existing system and implementation of appropriate operational

mitigations. This project will be the first installation of a DCV system in the UK and will

ensure Std. 3 DfT compliance for the airport.

The Social Construct Headers-230.png

Automotive Systems Installation

Cuzons has provided specialised works for Bentley and BMW in the Automotive sector supplying specialised services including facilitating the new Hoist Modification and Electrical Decommissioning.


Bentley Motors -
CQS Hoist Modification and Electrical Decommissioning
Client: IMAS Ltd / Bentley

Strip out of an automobile loading station including rotating hoist and re-install the hoist in a new location. The new hoist installation facilitated 90* rotation of car bodies to allow more flexibility in loading and movement. Decommission power, lighting, structured cabling and mechanical equipment within the former paint shop.


BMW Motors -
CQS Hoist Modification and Electrical Decommissioning
Client: IMAS Ltd / BMW Mini

Decommission and removal of the transfer system and telescopic fork system. Installation of a new Prohub and Springvale Fork System in its place.

Bentley Motors

CQS Hoist Modification and Electrical Decommissioning

Client: IMAS Ltd / Bentley

Strip out of an automobile loading station including rotating hoist and re-install the hoist in a new location. The new hoist installation facilitated 90* rotation of car bodies to allow more flexibility in loading and movement. Decommission power, lighting, structured cabling and mechanical equipment within the former paint shop.

BMW Motors

CQS Hoist Modification and Electrical Decommissioning

Client: IMAS Ltd / BMW Mini

Decommission and removal of the transfer system and telescopic fork system. Installation of a new Prohub and Springvale Fork System in its place.
